Monday, March 26, 2012

Time-indexed scheduling model

In the model I am working on we use a time indexed binary variable to model the schedule:

variables
   makespan
   x(j,t)
'=1 if job j starts in period t'
   s(j)
'start of job'
   z
'elastic infeasibility'
;
binary variable x(j,t);
positive variable
z;

When I solved this model for 1000 seconds, I observed that most of the action takes place in the first few nodes. I was thinking that the following simple algorithm may work to get better improvements:

  1. Solve for a shorter time with initial planning horizon giving us a makespan<horizon.
  2. Reduce planning horizon to the makespan, and resolve. This model is now smaller, and with MIPSTART we can quickly branch towards the last found solution.
  3. Repeat step 2 until out of time.

The loop looks like:

dt.optfile=1;
dt.reslim=200;

set iter/iter1*iter5/
;
loop
(iter,

solve
dt minimizing makespan using mip;
  x.fx(j,t)$(tval(t)+duration(j)>makespan.l)=0;
  z.fx$(z.l<0.01) = 0;
  dt.optfile=2;
);

This looks like a reasonable approach:

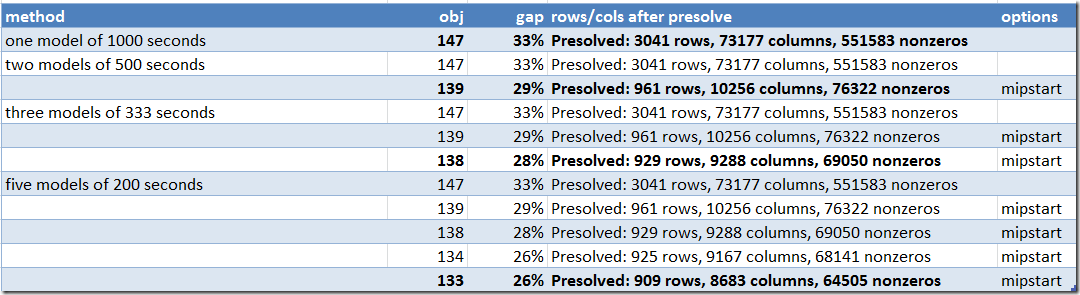

At least for this case it is better to solve 5 models for 200 seconds than one model for 1,000 seconds. Notice that we reduce the size of the problem in each cycle.
